  • Steve Johnson was a founding instructor at Pragmatic Institute, a role he held for more than 15 years before he left to start Under10 Playbook. In his return to Pragmatic Institute, Steve supports the complete learning path for product teams, ensuring they are fully armed for success.  Over the course of his career, Steve has helped thousands of companies and tens of thousands of product professionals implement product management processes. He has worked in the high-tech arena since 1981, rising through the ranks from product manager to chief marketing officer. Steve has experience in technical, sales and marketing management positions at companies that specialize in both hardware and software. In addition, he is an author, speaker and advisor on product strategy and product management.

product roadmaps

product roadmaps



“It’s hard to make predictions, especially about the future.” — Danish proverb

What does “second quarter” mean to you?



For most technical teams, the second quarter is when they work on a project from April to June, hoping to deliver it by late June or early July. For executives and marketing teams, second quarter means the project will be available on April 1 at 8:00am so they can start promoting it. And for sales teams, the second quarter means availability in mid-February so they can close deals April-June. And these different definitions can cause some serious confusions. The product roadmap has become one of the most popular forms of stakeholder communications. It’s shared with executives, sales, marketing, customers, and others as a clear outline for projects. Though for most product teams, finding the right level of detail is difficult. You want to be clear, but you don’t want to force yourself into a box.

There are generally two different types of roadmaps: date-driven roadmaps and phase-driven roadmaps. Here are the differences between the two.



Phase-Driven Roadmaps

The disconnect between dates and definitions is one of the reasons many product teams have moved from date-driven roadmaps to phase-driven roadmaps. It buckets elements into understandable, but not date-defined, segments which allows teams to move forward when things are ready but aren’t nailed to a date.

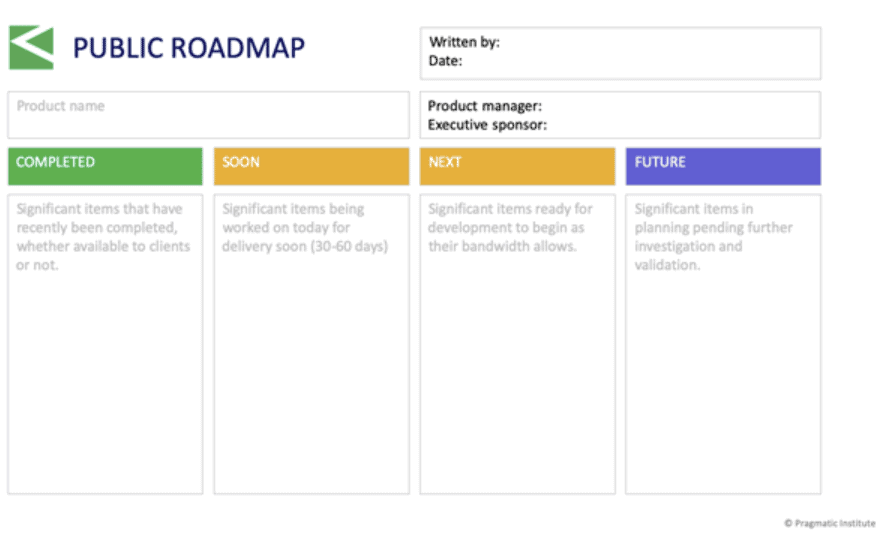

public roadmap



NOW

(shown as Completed in the graphic above) is for the many things that are completed and are available to your sales teams and customers. With so many projects constantly looming, it’s easy to forget all the work that we’ve accomplished and focused solely on the future. These are the projects and features you should emphasize with your customers.



SOON

is for those items that your team is actively building. You’ve nailed the requirements and acceptance criteria, and you’ve probably already seen some prototypes and even some working demos. Barring any complications, SOON items will be available in a few iterations, and we can safely talk about them with sales teams and customers.



NEXT

is used for requirements and stories that are fully documented but not yet begun. You know what they are but haven’t started working on them. They are part of the continually prioritized backlog of work to be done when resources become available.



FUTURE

is everything else. These are the products, options, features, requirements, and stories that are in the queue to be defined. We don’t really know what they are yet. We don’t know their size, and we don’t know their acceptance criteria. FUTURE is for those “yeah, it’s on my list” items.



We know that NOW items are available today, and SOON items will likely be available in the next release. Assuming our resources free up as planned, we can take a guess at some of the high-priority NEXT items. We have no idea when the FUTURE items will be available and can’t make any guesses until we know more about the item.



Date-Driven Roadmaps

The typical date-driven roadmap looks like this:



date-drive roadmap



This roadmap shows the focus for product activities over the next 18 months, including themes, markets, personas and goals. What’s missing from this roadmap is a HUGE disclaimer that these are plans, not commitments. Many things can go wrong over the next 18 months to derail some or all of these plans.

What happens to your roadmap when a big sale requires an unplanned feature? What happens to your roadmap when your dev team is re-allocated to a new project? For that matter, what happens when a small story turns out to be a huge story—one that is a prerequisite for many others?

We’re not talking an exact science here. Product design and development is more of a craft than a science after all.

Here’s a simple way to communicate: stick to the truth. What do you know is true? “I know we will release this feature in the next two weeks. I’ve seen it.”
“I know we’re working on another feature that will ship in the next two months—because we’re working on it now and I’ve seen preliminary demos.”  Tell that to your various audiences.

“But Steve, when will those items in the FUTURE column be delivered?”

“After we begin working on them.”

That is, we’re not working on them now, but we will work on them in the future. And we’ll know they will be likely to ship soon after we begin working.



Stick to the truth. It’s easier to remember.

Author

  • Steve Johnson was a founding instructor at Pragmatic Institute, a role he held for more than 15 years before he left to start Under10 Playbook. In his return to Pragmatic Institute, Steve supports the complete learning path for product teams, ensuring they are fully armed for success.  Over the course of his career, Steve has helped thousands of companies and tens of thousands of product professionals implement product management processes. He has worked in the high-tech arena since 1981, rising through the ranks from product manager to chief marketing officer. Steve has experience in technical, sales and marketing management positions at companies that specialize in both hardware and software. In addition, he is an author, speaker and advisor on product strategy and product management.

Author:

Other Resources in this Series

Most Recent

Man holding elbow with tennis racket in hand
Article

[Distinctive Competency] What Companies Can Learn from the Tennis Elbow Queen

Focusing on an extremely specific segment of an industry can be a highly successful distinctive competency. Here are the lessons that companies can learn from the Tennis Elbow Queen.
SEO with a magnifying glass
Article

How to Write SEO-Friendly Content

SEO-friendly content is a time-intensive strategy. But these tactics ensure a healthy website where every page considers readers and robots.
Article

Meet The 2022 Pragmatic Alumni Community Winners

Two years later—and more than 20,000 members later—we’re celebrating this unique community with the inaugural 2022 Pragmatic Alumni Community Awards.
Image featuring a compute with a content planning calendar
Article

8 Sources for an Outside-In Content Planning Process

We've identified several sources for listening. As a result, you'll find market-driven inspiration for your content strategy and ensure the audience is always the focus.
Article

Why the Pragmatic Alumni Community is the Place to be for Product Professionals

In May 2020, we were thrilled to launch the first community built specifically for product managers, and We’re celebrating this unique community with the inaugural 2022 Pragmatic Alumni Community Awards.

OTHER ArticleS

Man holding elbow with tennis racket in hand
Article

[Distinctive Competency] What Companies Can Learn from the Tennis Elbow Queen

Focusing on an extremely specific segment of an industry can be a highly successful distinctive competency. Here are the lessons that companies can learn from the Tennis Elbow Queen.
SEO with a magnifying glass
Article

How to Write SEO-Friendly Content

SEO-friendly content is a time-intensive strategy. But these tactics ensure a healthy website where every page considers readers and robots.

Sign up to stay up to date on the latest industry best practices.

Sign up to received invites to upcoming webinars, updates on our recent podcast episodes and the latest on industry best practices.

Training on Your Schedule

Fill out the form today and our sales team will help you schedule your private Pragmatic training today.

Subscribe

Subscribe

Training on Your Schedule

Fill out the form today and our sales team will help you schedule your private Pragmatic training today.
